The €300 Million Confession
The synergy case Saipem and Subsea7 published in July 2025, and the theory of harm the European Commission published in July 2026, are built from the same industrial facts.
The €300m synergy Saipem and Subsea7 put to investors rests on the same facts as the Commission’s case against the merger, and no remedy yet proposed reconciles the two.
- 01The synergy depends on fewer overlapping bids and a tighter fleet.In merger control, that is the removal of a bidder and the rationalisation of capacity.
- 02Completion has moved from the second half of 2026 into 2027.The Commission stopped the clock on 25 August. On ZMK’s calculation, a 16 December decision moves to around the second week of January 2027.
- 03SURF prices had already risen before the merger.Subsea margins at Subsea7 and TechnipFMC rose by about 520 and 320 basis points year on year, with backlog at or near record levels.
- 04ExxonMobil, Petrobras and TotalEnergies filed against the deal in Brazil.The Commission’s preliminary finding is that customers may not be able to resist price increases.
- 05No remedy adds the vessels the market lacks.Behavioural commitments add no hulls, and any divestment comes from the same fleet as the savings. Buyers tendering for 2028 work should price bidder-count risk now.
The synergy case and the Commission’s theory of harm rest on the same facts.

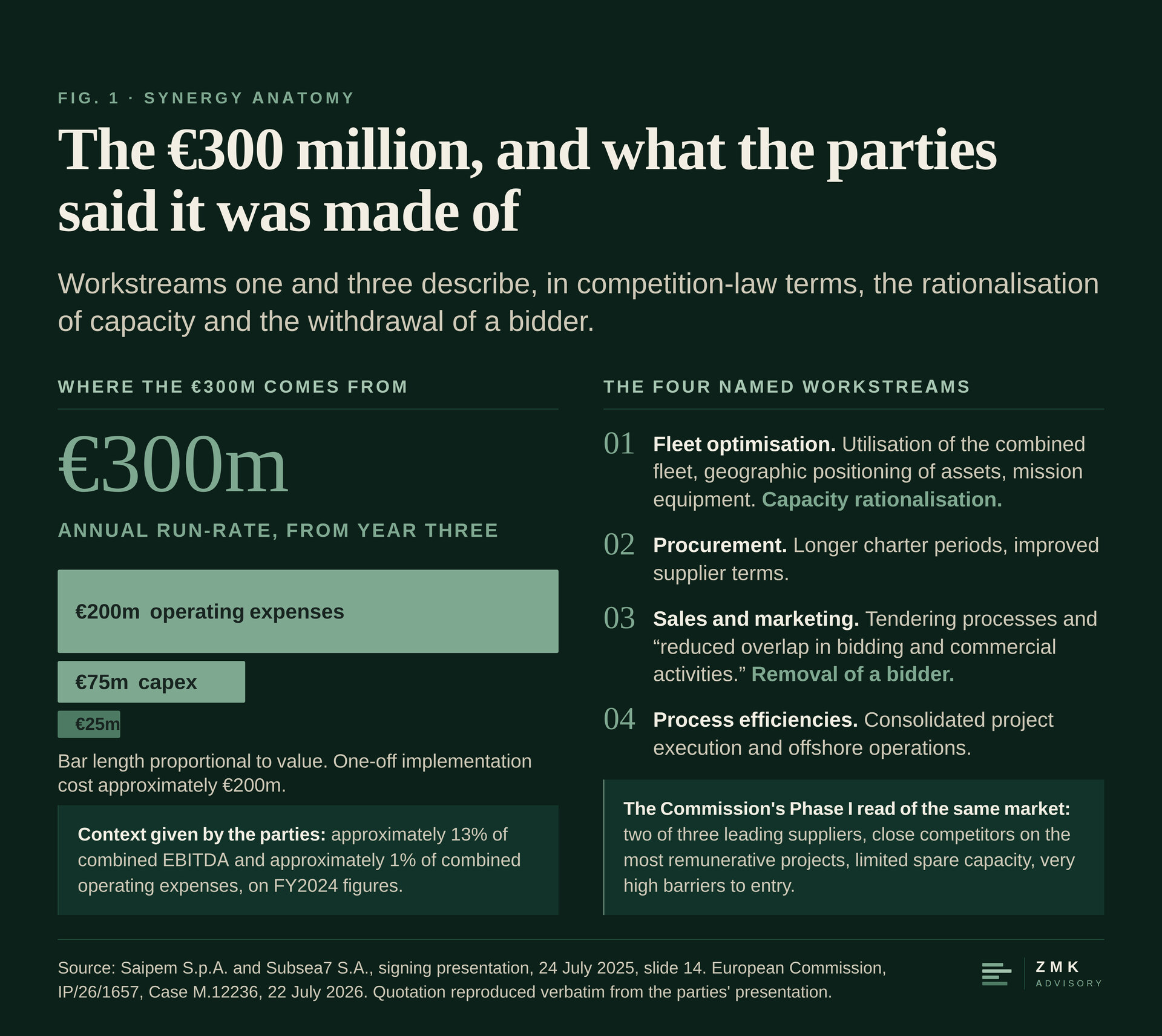

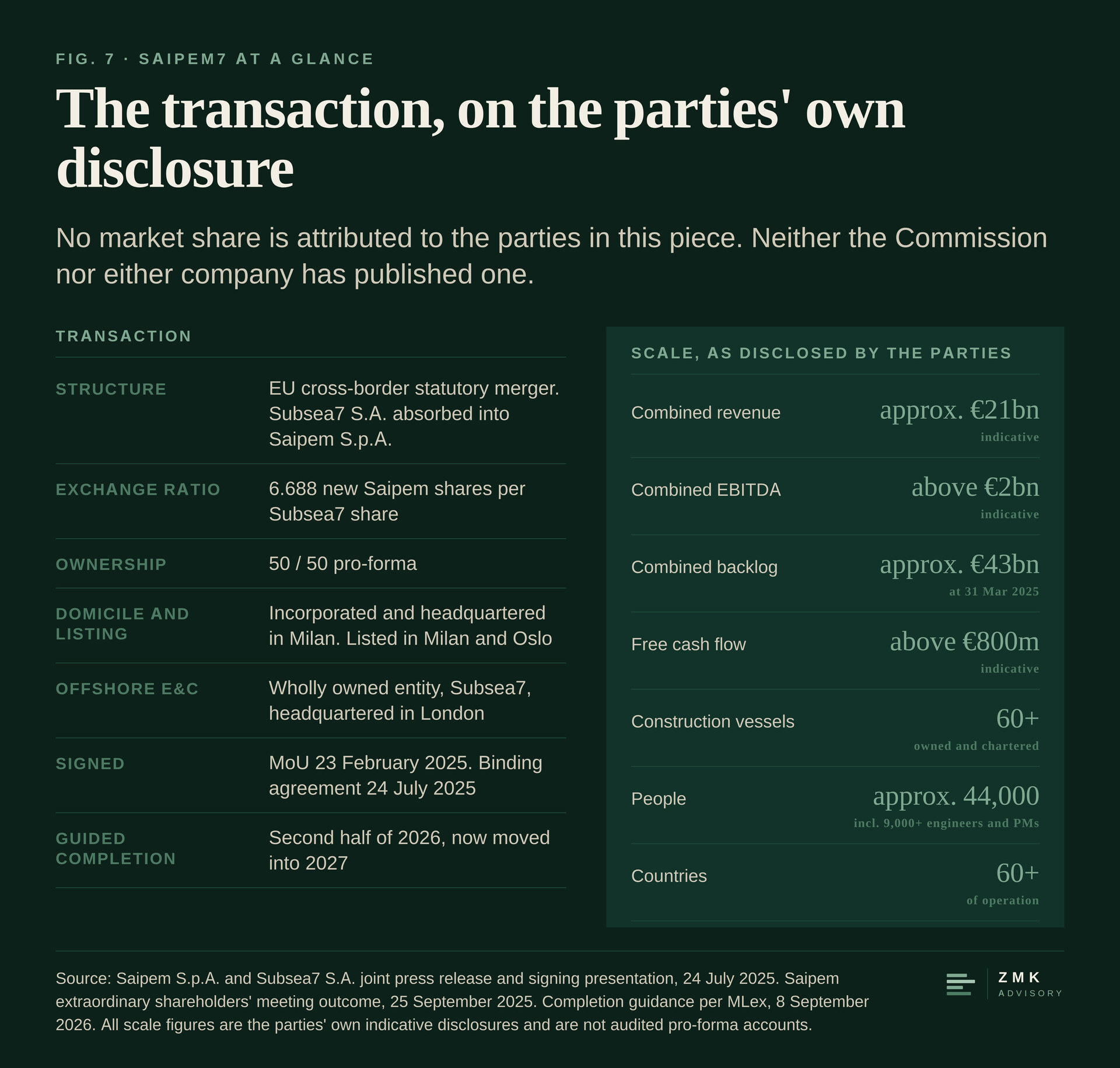

€300 million a year. That was the run-rate synergy Saipem and Subsea7 put in front of investors on 24 July 2025, the day they signed the binding agreement to merge into a single company to be called Saipem7.1 On the parties’ own FY2024 arithmetic the figure represents approximately 13 per cent of combined EBITDA and approximately 1 per cent of combined operating expenses, delivered at a one-off implementation cost of approximately €200 million and reaching full run-rate in year three.2
The composition of the number matters more than its size. The parties identified four sources. Fleet optimisation came first, defined as improved utilisation of the combined vessel fleet, better geographic positioning of assets and rationalised mission equipment. Procurement came second, through longer charter periods and improved supplier terms. Consolidation of project execution came fourth. Third on the list was sales and marketing, and the parties described it in seven words: “reduced overlap in bidding and commercial activities.”2
Twelve months later, on 22 July 2026, the European Commission opened an in-depth Phase II investigation into the same transaction under Article 6(1)(c) of the EU Merger Regulation.3 Its preliminary findings were that the two companies are two of the three leading suppliers of subsea umbilicals, risers and flowlines in the world; that they compete closely with each other, particularly on the most complex and most remunerative projects; that only one comparable competitor would remain, with other rivals considerably smaller and limited in their ability to compete across the board; that spare capacity is limited and barriers to entry and expansion very high, explained partly by the investment required in highly sophisticated vessels; and that customers, despite being large and sophisticated, “may not be able to resist price increases.”3
A synergy programme resting on fewer overlapping bids and a more tightly optimised fleet describes, in the vocabulary of merger control, the removal of a bidder and the rationalisation of capacity. The parties disclosed it because disclosure was required of them and because it is the ordinary industrial logic of consolidation. The consequence is that the value case and the theory of harm rest on the same underlying facts. That is why the file has proved harder than the market priced it, and why a completion both companies had guided to for the second half of 2026 has now moved into 2027.

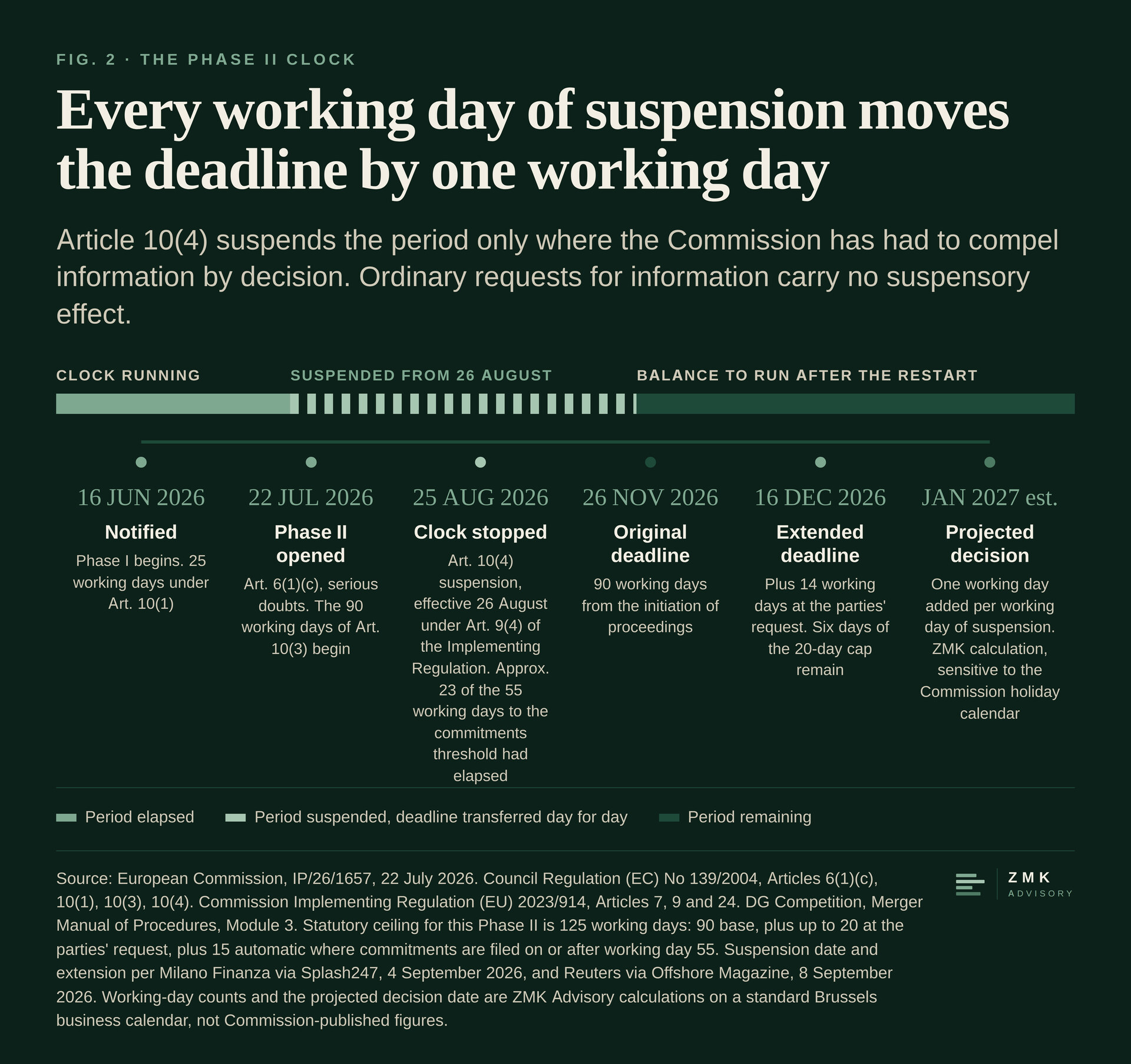

The suspended clock moves completion into 2027.
The transaction was notified to the Commission on 16 June 2026.3 Phase I ran and produced serious doubts. Proceedings were initiated on 22 July, and under Article 10(3) of the Merger Regulation4 the Commission then had 90 working days from the date of initiation, not from the date of notification, to reach a decision. That produced a statutory deadline of 26 November 2026.3
The same provision allows the notifying parties to request an extension, once only, no later than 15 working days after initiation, with total extensions capped at 20 working days.4 The parties requested 14, moving the deadline to 16 December and leaving six working days of that allowance unused.5 A further 15 working days attaches automatically if commitments are offered on or after the 55th working day from initiation, which sets the absolute statutory ceiling for this Phase II at 125 working days before any suspension is applied.6 A remedy filed late in the process therefore lengthens the process again.
On 25 August the Commission stopped the clock.7
The mechanism is narrower than the phrase “pending further information” suggests. Under Article 10(4) of the Merger Regulation, Phase II periods are suspended only where, owing to circumstances for which one of the undertakings is responsible, the Commission has had to compel information by formal decision under Article 11(3) or order an inspection under Article 13.4 Article 9 of the Implementing Regulation sets out the grounds, which include the supply of incomplete or incorrect information in response to a simple request, failure to submit to an inspection, and failure to inform the Commission of material changes to the facts contained in the notification.8 An ordinary request for information under Article 11(2) does not stop the clock.6 The Commission’s own guidance describes suspensions as reserved for “a handful of very complex in-depth investigations.”9
The Commission has not published the grounds engaged in this case, and the trade press reporting is limited to a source stating that the pause concerns a substantial information request rather than remedy discussions.10 Which limb of Article 9 was used is therefore not on the public record, and should not be assumed.
What can be established is duration. A suspension expires only when the complete and correct information is received, or when the Commission decides the information is no longer necessary.8 The precedents are long. In Oracle/PeopleSoft the periods were suspended on 14 April 2004 and the timetable resumed on 7 October, close to six months.11 In Orange/VOO the Commission adopted an Article 11(3) decision on 26 October 2022 and the notifying party complied on 30 January 2023, a suspension of approximately three months.12
Article 9(4) of the Implementing Regulation provides that suspension begins on the working day following the event that causes it, so a decision taken on 25 August stops the clock from 26 August.8 On that basis, and applying the Brussels working-day calendar which excludes Saturdays, Sundays and Commission holidays,6 the suspension had run for approximately 12 working days by 10 September 2026. On a ZMK Advisory calculation, and allowing for the Commission’s year-end closure, that alone displaces a 16 December decision to around the second week of January 2027. The count is sensitive by a day or so to the Commission’s own holiday schedule and to the exact date of the Article 11(3) decision, which has not been published. The figure is our calculation and not a Commission-published date, and the Commission publishes provisional deadlines, extensions and suspensions on the case register for M.12236, which remains the authoritative source.13 The direction, however, is not in dispute. The second-half-of-2026 completion both companies have guided to since February 2025 is no longer available.10

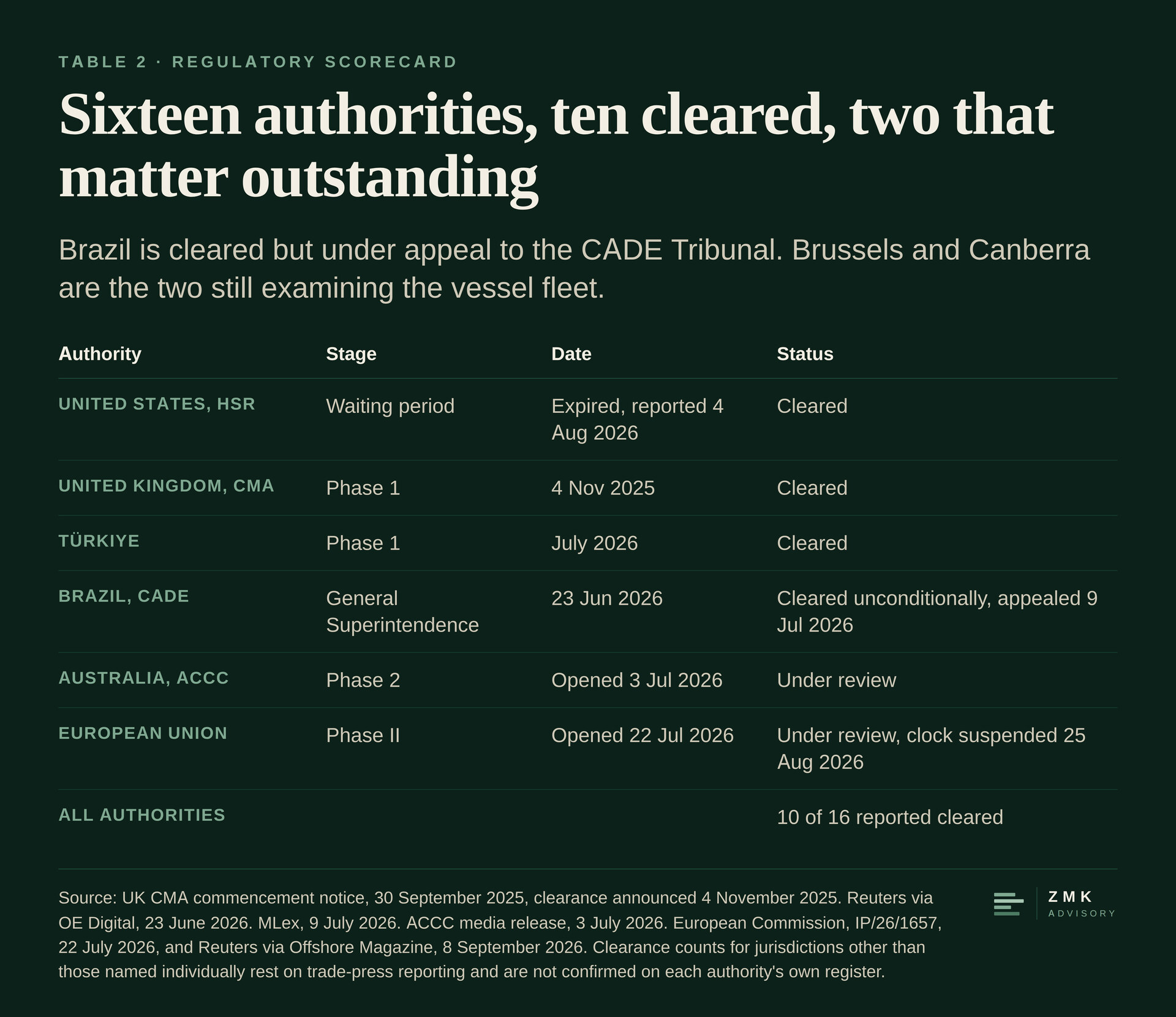

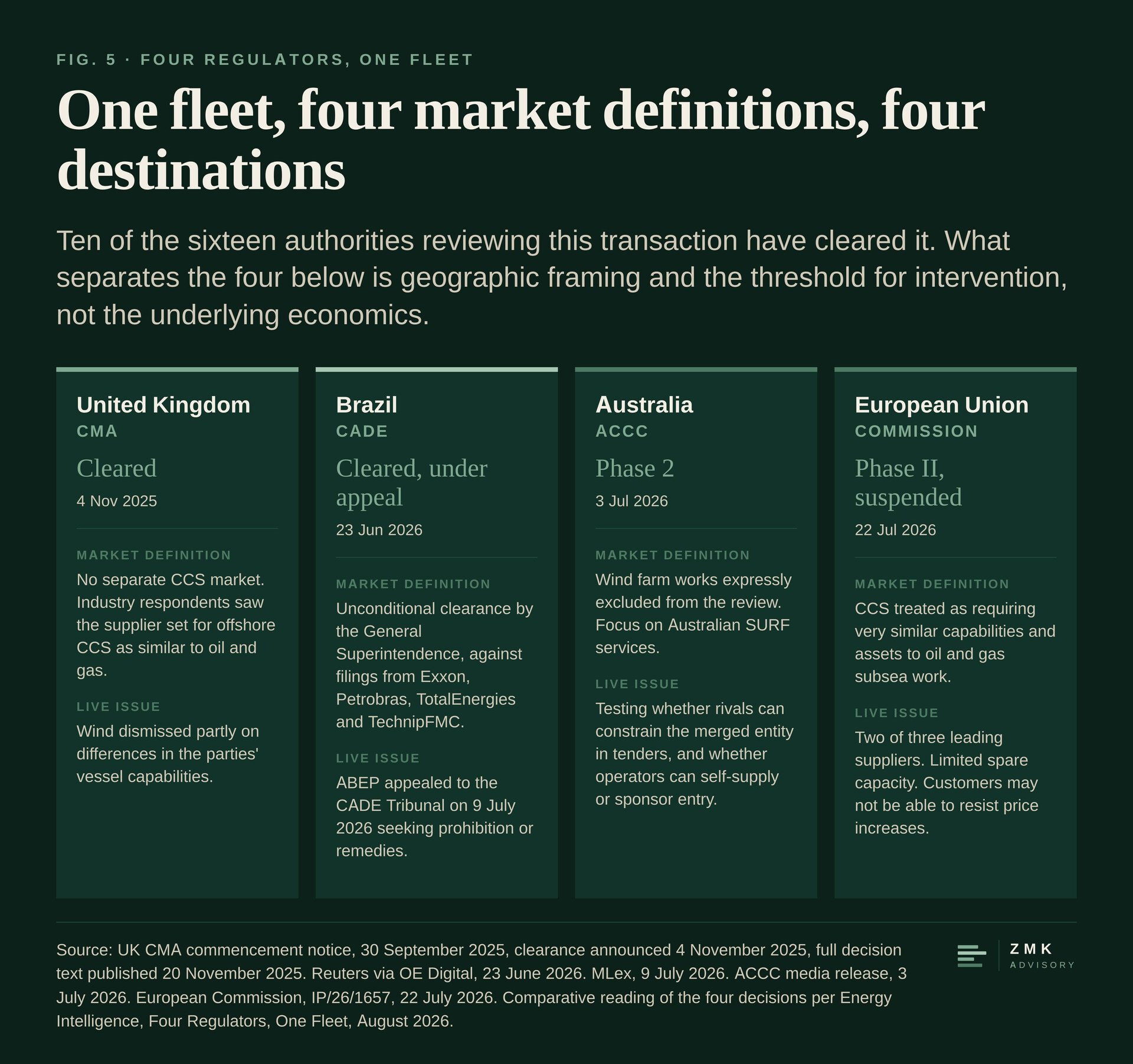

Ten of the sixteen competition authorities reviewing this transaction have already cleared it, Turkey among them in July.7 Brazil’s CADE granted unconditional clearance in June.14 The United Kingdom’s Competition and Markets Authority cleared the deal at Phase 1 in November 2025.15 The United States waiting period under the Hart-Scott-Rodino Act expired at the end of July.16 The two that have not are the two that will determine what the vessel fleet looks like.

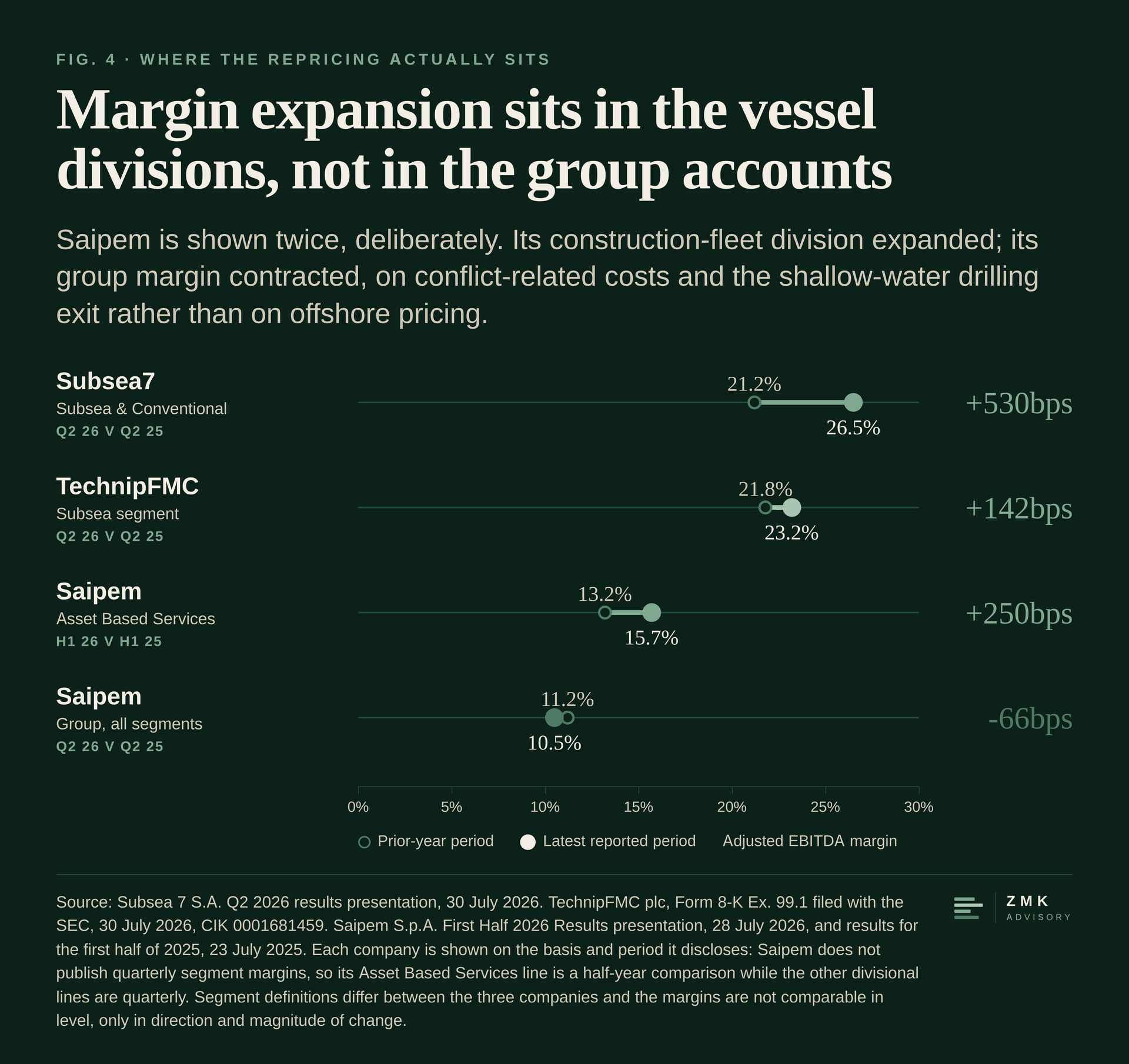

The repricing preceded the merger.
The concern about SURF pricing is frequently discussed as a forecast of what Saipem7 might do. The available evidence describes something that has already happened.

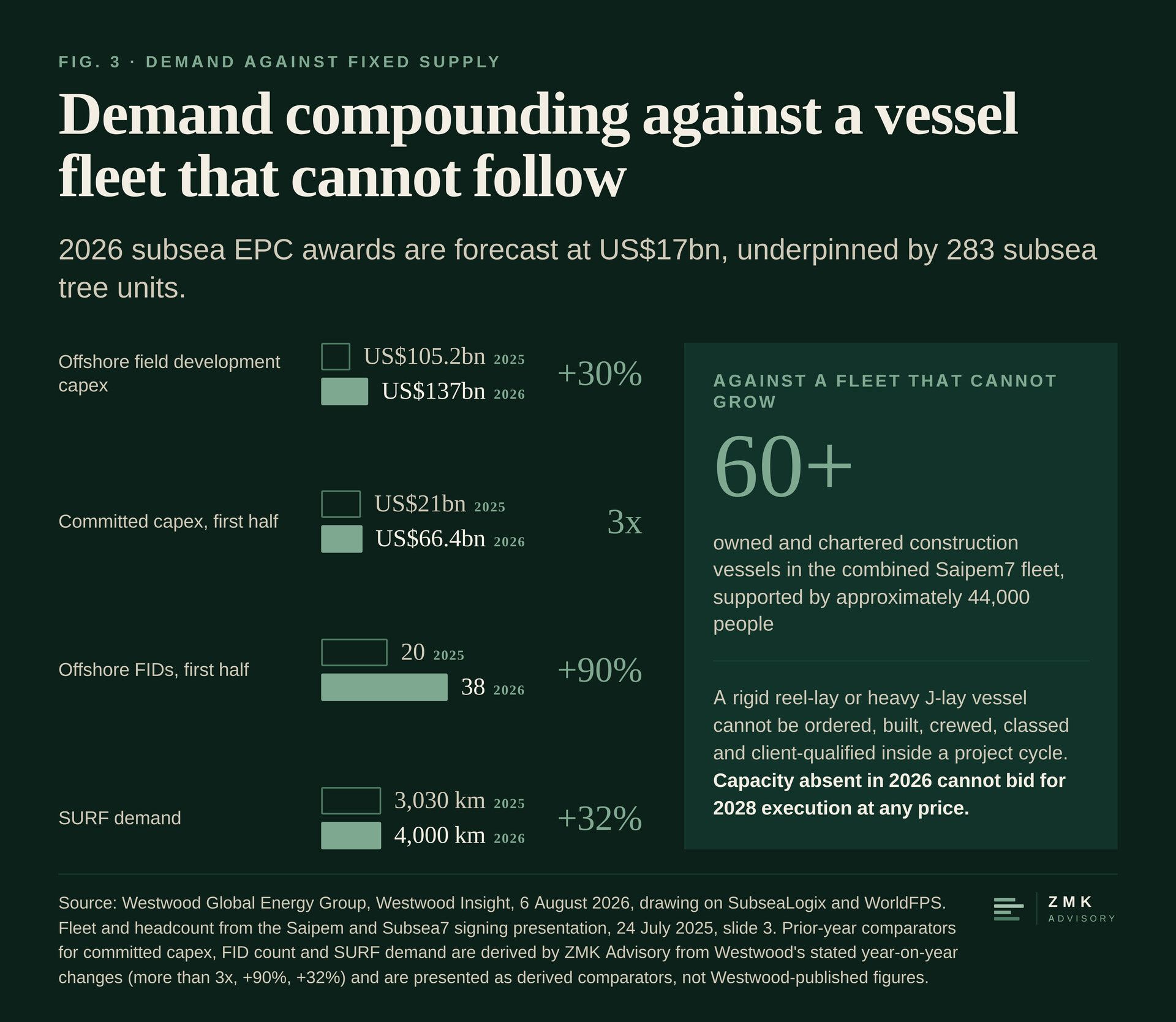

Westwood forecasts global offshore field development capex of US$137 billion in 2026, an increase of 30 per cent on the US$105.2 billion recorded in 2025. Thirty-eight offshore field final investment decisions were taken in the first half of 2026, an increase of 90 per cent on the first half of 2025, committing US$66.4 billion of capex, more than three times the prior-year figure. Full-year subsea EPC awards are forecast at US$17 billion, underpinned by 283 subsea tree units. Demand for SURF in 2026 is forecast at approximately 4,000 kilometres, an increase of 32 per cent year on year.17

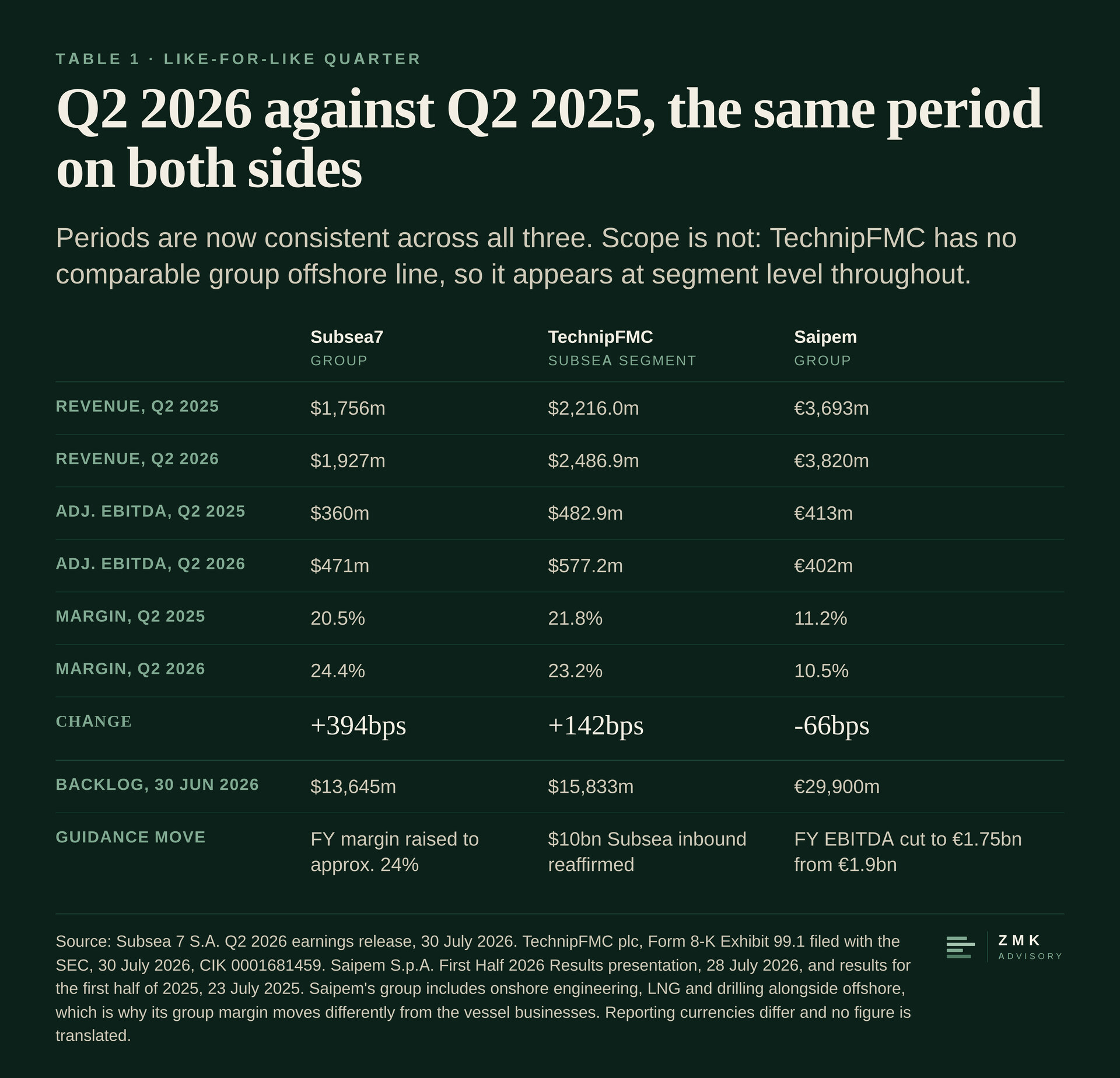

Against that demand, the three companies the Commission identifies as the market leaders reported second-quarter results within eight days of one another at the end of July 2026.
Subsea7 reported adjusted EBITDA of $471 million on revenue of $1.9 billion, a margin of 24 per cent against 21 per cent a year earlier, and raised full-year margin guidance from approximately 23 per cent to approximately 24 per cent. Backlog stood at $13.6 billion, with the Subsea and Conventional book at an all-time high of $11.8 billion.18 Within that division the adjusted EBITDA margin was 26.5 per cent, an increase of approximately 520 basis points year on year.19
TechnipFMC, the third leader and the only comparable competitor the Commission expects to remain, reported Subsea adjusted EBITDA of $577.2 million at a margin of 23.2 per cent, up 320 basis points year on year, on Subsea backlog of $15.8 billion.20 Its subsea opportunities list has passed $30 billion and has grown for eight consecutive quarters.21
Saipem is the exception, and the exception is instructive. On a like-for-like quarter its group adjusted EBITDA fell 2.8 per cent to €402 million on revenue of €3.82 billion, a margin of 10.5 per cent against 11.2 per cent in the same quarter of 2025.22 That missed analyst consensus and prompted a cut in full-year guidance to €1.75 billion from €1.9 billion.23 But Saipem’s group accounts blend offshore construction with onshore engineering, LNG and drilling, and the guidance cut was attributed to roughly €70 million of conflict-related costs already incurred and to the disposal of the shallow-water drilling business, not to offshore pricing.22 Its Asset Based Services division, the one that owns and runs the construction fleet, moved the other way: a first-half margin of 15.7 per cent against 13.2 per cent, which the company attributes to a better project mix and a higher utilisation rate of the construction fleet.22
That divergence is the finding, not a complication of it. Where a company’s results are driven by vessels, margin expanded. Where they are diluted by everything that is not vessels, it did not.
Three balance sheets, at or near record backlog, with margins expanding in the same period in which the European Commission opened an investigation into whether the sector was at risk of becoming more expensive. One of the three raised guidance in the same quarter.
The mechanism is physical rather than commercial. In high-end offshore EPCI, price is set by the availability of a small number of specialised vessels rather than by the number of contractors submitting bids. The combined Saipem7 fleet would comprise more than 60 owned and chartered construction vessels, supported by approximately 44,000 people including more than 9,000 engineers and project managers.2 A rigid reel-lay or heavy J-lay vessel cannot be added inside a project cycle. Capacity that does not exist in 2026 cannot bid for work executing in 2028.
Global fleet counts also overstate what is available in any particular basin. Saipem told investors in April 2026 that its Middle East construction and drilling fleet is largely dedicated to the region, so that executing work in the Gulf requires no additional vessels to enter it and no units to transit the Strait of Hormuz for work elsewhere.24 That is presented as an operational strength, and it is one. It also means the units supporting an €11.5 billion regional backlog are not contestable capacity for a project offshore West Africa or Western Australia.
The honest reading is uncomfortable in both directions. The merger does not create pricing power in SURF, because pricing power in SURF is already visible in three sets of quarterly margins. What the merger does is remove the residual competitive discipline operating inside a market that is already tight, through a programme whose first named workstream is fleet optimisation.
The largest buyers filed against the deal.
The most consequential evidence in this file was submitted by the buyers.
When Brazil’s CADE reviewed the transaction, ExxonMobil, Petrobras and TotalEnergies all filed against it, joined by TechnipFMC as a competitor. Exxon argued the deal would concentrate SURF contracting and reduce customer choice. Petrobras argued that it relies on the parties for its core business.25 Reuters reported the objecting majors’ concern that the combined firm would be positioned to impose additional costs, delay projects and push clients toward exclusive long-term contracts.14 The Brazilian producers’ association, ABEP, told CADE that “a total prohibition of the operation would be the appropriate competitive solution,” arguing that in a structurally constrained market no remedy, including the divestment of vessels, would be sufficient.26
CADE’s General Superintendence cleared the transaction unconditionally on 23 June 2026.14 ABEP appealed to the CADE Tribunal within three weeks.27 The Australian Competition and Consumer Commission escalated to a Phase 2 assessment on 3 July, its commissioner stating that the acquisition “could substantially lessen competition” in subsea infrastructure critical to Australian offshore oil and gas projects.28 The European Commission opened Phase II on 22 July.3
Three authorities reached three positions on one transaction inside five weeks. The variable is market definition: whether SURF constitutes a distinct product market or forms part of a broader offshore engineering market, and whether the relevant geographic frame is global or basin by basin. Australia’s assessment carries an additional feature, since the transaction is among the first energy-services tests of the mandatory formal merger regime that took effect there on 1 January 2026, with no domestic precedent for the ACCC to be bound by.28
Two elements of the Commission’s reasoning have received less attention than they warrant. The first is that it explicitly linked SURF capability to carbon capture and storage, finding that very similar assets and capabilities appear necessary to compete for CCS work today and in future.3 European decarbonisation infrastructure therefore sits inside the same vessel bottleneck as oil and gas tiebacks. The second is the buyer-power finding. Some of the largest listed energy companies in the world have effectively told regulators, in writing, that they cannot resist price increases from their own contractors. If that finding survives Phase II it is close to dispositive on the SURF theory of harm, and it is difficult to rebut with the standard countervailing-power arguments.
No remedy adds the vessels the market lacks, so buyers should act before Brussels decides.

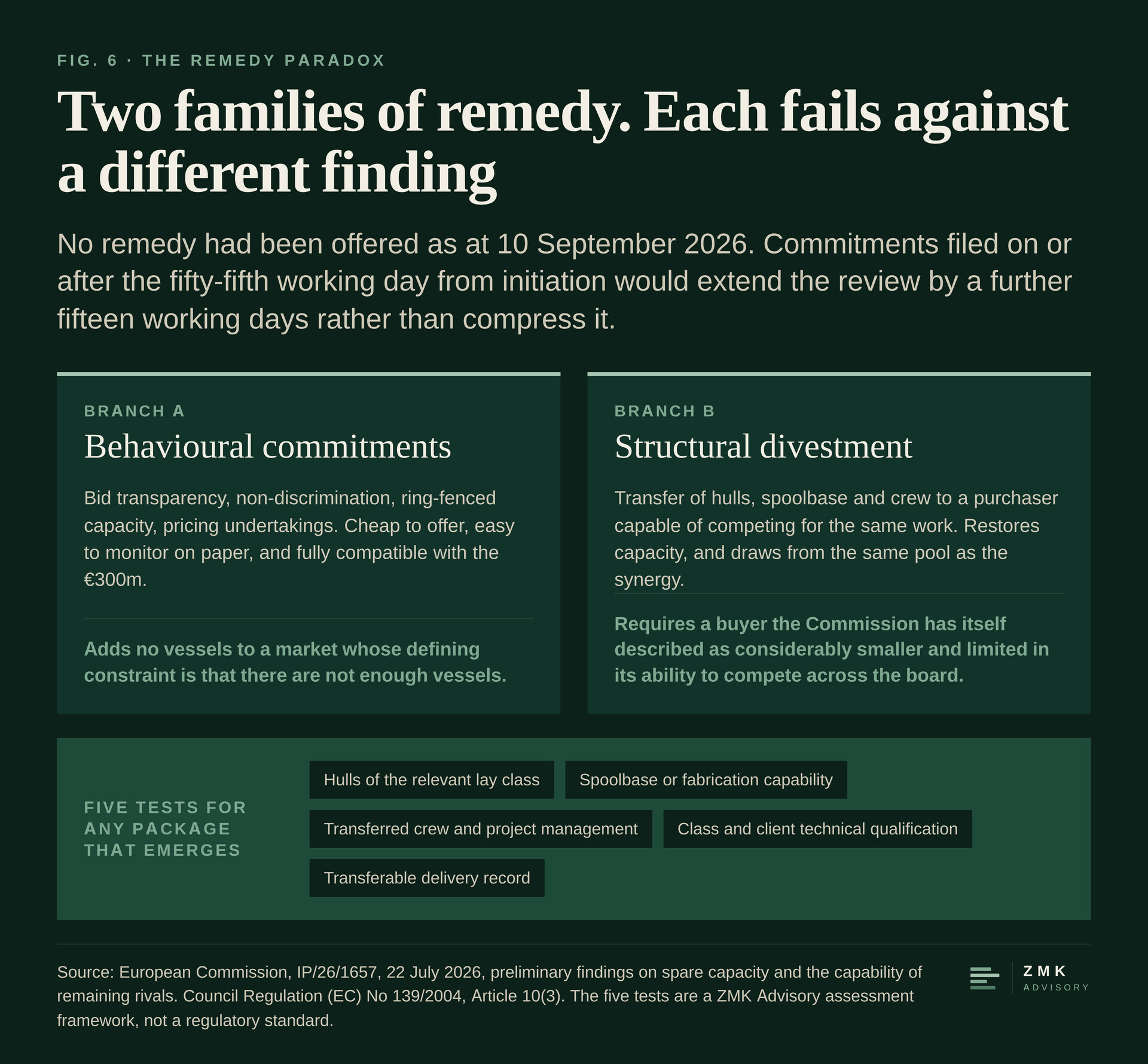

Two families of remedy are available. Behavioural commitments, whether bid transparency, non-discrimination or capacity ring-fencing, add no vessels to a market whose defining constraint is that there are not enough vessels. Structural divestment does add contestable capacity, but it requires a purchaser, and the Commission’s own preliminary finding is that the remaining competitors are considerably smaller and limited in their ability to compete across the board.3 That does not make divestment impossible; it changes what divestment can realistically achieve. A remedy cannot manufacture a third full-suite SURF competitor, because a package capable of that would need vessels, spoolbase capacity, crew, technical qualification and a client-transferable delivery record, which is most of what distinguishes a tier-one contractor from a mid-tier one. What a remedy can do is move specific assets, individual reel-lay or heavy-lay hulls, or a regional spoolbase, to a mid-tier contractor or a financially backed platform, restoring contestability in particular scopes or particular basins rather than across the market. That is the more probable shape of any package here, and it carries its own consequence: every hull and every base that leaves the combined fleet is drawn from the same pool as the fleet-optimisation savings that form the first pillar of the €300 million.2
The remedy is also drawn from the same pool as the €300 million. Fleet optimisation and reduced bidding overlap are the two synergy workstreams most exposed to a structural or behavioural fix, and they sit first and third on the parties’ own list.2
For operators, the decision cannot wait for Brussels. Capacity for 2028 execution is being allocated in tender rounds running now, under a market structure that will not have a settled name until 2027 at the earliest. Three practices distinguish the buyers who manage this well. The first is analysing concentration at the level of the vessel class the scope actually requires, in the basin where the work sits, rather than accepting a global market definition that may not describe the project. The second is writing tenders that price bidder-count risk explicitly, rather than assuming a three-bidder field persists to award. The third is opening capacity conversations early, on the understanding that in an asset-constrained market the scarce commodity being contracted is not a contractor but a hull with an available window.
The €300 million was always a defensible industrial number, and it remains one. What has changed is that a regulator has now read the same disclosure and drawn the opposite conclusion from it, and no remedy yet proposed reconciles the two readings.
